PAW Demolition

Port and Waterfront Facility Demolition in Florida: Scope, Permitting, and Contractor Requirements

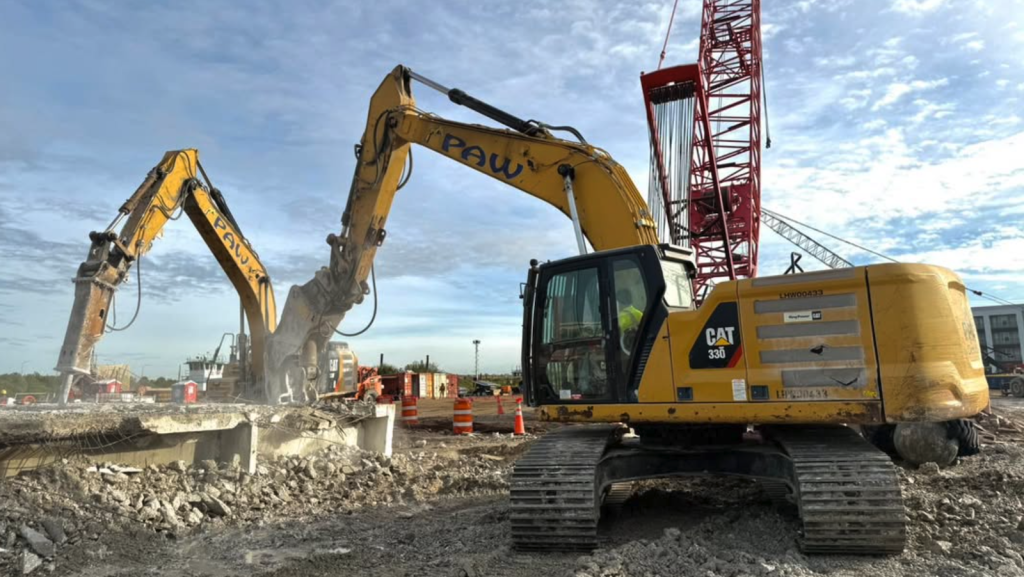

Howard Frankland Bridge Tampa, FL demolition by PAW Demolition

Quick Answer: Waterfront and port facility demolition in Florida involves tearing down seawalls, bulkheads, piers, pilings, and upland structures in or adjacent to navigable waters. These projects require permits from FDEP, USACE, and local jurisdictions before work begins, and must be performed by contractors with documented coastal demolition experience, appropriate licensing, and a strong environmental compliance record.

Key Takeaways

  • Coastal and waterfront demolition is one of the most permit-intensive scopes in Florida, requiring sign-off from USACE, FDEP, and local building authorities before a single structure comes down.
  • USACE Section 10 permits apply to any demolition work in, over, or affecting navigable waters. FDEP Environmental Resource Permits govern water quality, submerged lands, and environmental impact.
  • Upland structures on waterfront properties require standard county or municipal demolition permits in addition to the water-side permitting layer.
  • Hazardous materials, including asbestos, lead paint, and CCA-treated timber, must be abated and documented before structural demolition begins.
  • Contractors must bring marine demolition experience, owned heavy equipment, and a documented safety record to this type of project. General commercial demolition credentials alone are not sufficient.

Port and waterfront infrastructure across Florida is aging. From working commercial terminals to decommissioned marine facilities and municipal waterfront properties, owners, developers, and general contractors are increasingly managing demolition scopes that were built decades ago and never designed to be straightforward to remove. The structures sit at the intersection of land and water, regulated by multiple agencies with overlapping jurisdiction, and the environmental stakes are real.

This is not a standard commercial teardown. Work in, over, or adjacent to navigable waters triggers a permitting stack that most demolition contractors have never navigated. Getting that process wrong, or awarding the scope to a contractor without the right experience, can result in stop-work orders, fines, and significant project delays. This article walks through what coastal and waterfront demolition actually involves in Florida, what permits are required, and what to look for when qualifying a contractor.

What Waterfront Facility Demolition Actually Includes

Waterfront demolition scopes vary significantly depending on whether the work is primarily in-water, upland, or a combination of both. Most port and coastal facility teardowns involve all three zones.

Water-Side and Coastal Structures

The most complex portion of any waterfront demolition involves structures built in or directly adjacent to the water. This typically includes seawalls and bulkheads, concrete or steel sheet pile walls constructed along the shoreline to retain soil and protect against wave action. It also includes piers and wharves, which are pile-supported deck structures extending out over the water, along with the pilings themselves, fender systems, dolphins, mooring hardware, and boat ramps.

Each of these elements presents distinct removal challenges. Concrete seawall caps and steel sheet pile walls require different equipment and techniques than timber pier decking or precast concrete piles. Contractors need familiarity with tidal work windows, water-adjacent debris containment, and the turbidity controls required by FDEP and USACE permit conditions.

Upland Structures on Port and Waterfront Properties

Most waterfront facilities include substantial upland development: warehouses, storage buildings, crane structures, fuel and utility systems, and ancillary office buildings. These structures are governed by standard Florida building demolition requirements under the Florida Building Code and local jurisdiction permits, but they cannot be treated in isolation from the water-side scope. Sequencing matters. In most cases, upland demolition is completed first to avoid debris migration toward the water before water-side structures are addressed.

Debris and Material Disposition

Demolished concrete from seawalls, piers, and upland structures cannot simply be stockpiled on-site or pushed into the water. Permit conditions specify how debris must be contained, transported, and disposed of. Concrete is typically hauled to a permitted facility or, where a contractor operates an on-site recycling program, processed into usable aggregate. PAW Demolition processes demolished concrete at its own concrete recycling facility, converting it into aggregate for reuse. Steel from pilings and sheet pile walls is typically salvaged. CCA-treated timber requires separate handling and disposal at an authorized facility per FDEP guidance.

Pro Tip: Ask your demolition contractor for the debris management plan before contract award. A contractor without a clear answer for how CCA-treated timber pilings will be handled, or where demolished concrete will go, is a risk flag. These decisions affect permit compliance, project cost, and schedule.

The Permitting Stack for Coastal and Waterfront Demolition in Florida

No other demolition category in Florida involves as many overlapping regulatory authorities as waterfront work. Depending on project location and scope, a contractor may need federal, state, and local permits before mobilizing. These processes run in parallel but must each be satisfied independently.

USACE Section 10 Permit (Rivers and Harbors Act)

Section 10 of the Rivers and Harbors Act of 1899 requires authorization from the U.S. Army Corps of Engineers for any work in, over, or under navigable waters of the United States. For demolition purposes, this covers the removal of piers, seawalls, bulkheads, pilings, docks, and any other structure in or affecting navigable waters. It also applies to excavation, dredging, or any alteration to the course, location, or capacity of a navigable water body.

In Florida, USACE administers Section 10 permits statewide. For lower-impact scopes, a Nationwide Permit may apply, which is a pre-authorized general permit for common activities that carry a defined review timeline. For complex or high-impact projects, an Individual Permit is required. Individual Permits include a public notice and comment period of up to 30 days and a more extensive environmental review, which makes early engagement with USACE essential.

FDEP Environmental Resource Permit (ERP)

The Florida Department of Environmental Protection governs water quality, wetlands, and submerged lands through its Environmental Resource Permit program. Florida briefly assumed Section 404 permitting authority from USACE in 2020, but a federal court vacated that assumption in February 2024. As of that ruling, Section 404 authority reverted fully to USACE, meaning Florida waterfront and coastal projects requiring a 404 permit must go through USACE rather than FDEP.

FDEP’s Submerged Lands and Environmental Resources Coordination (SLERC) program governs consent of use for work on state-owned submerged lands, which applies regardless of whether a project also requires a federal 404 permit. ERP permit timelines range from 30 to 180 days depending on project complexity and environmental sensitivity. Projects near seagrass beds, mangroves, or other protected resources take longer, and pre-application coordination with FDEP is advisable on any project involving in-water demolition.

Local Building Permits

Demolition of any upland structure on a waterfront property still requires a standard building demolition permit through the applicable county or municipal building department. Florida Statute §553.79 governs the building permit process statewide, and local jurisdictions add their own requirements on top of that baseline. Permit requirements vary significantly by county, and confirming what each jurisdiction expects before submitting saves time. Utility disconnection verification and an engineering survey of the structure under 29 CFR 1926 Subpart T are standard prerequisites before demolition work begins.

Pro Tip: Federal and state permitting for waterfront demolition can take six months or more for Individual Permit scopes. GCs who wait until the demolition subcontractor is selected to begin permit coordination routinely face schedule compression that pushes the entire project. Start the USACE and FDEP pre-application process as early as possible, ideally during design development.

Hazardous Materials and Environmental Compliance

Waterfront structures built before the early 1980s almost universally contain hazardous materials that must be addressed before any structural demolition begins. This is non-negotiable under federal law and Florida regulation, and it must be sequenced correctly to avoid enforcement exposure.

Asbestos and Lead-Based Paint

EPA NESHAP regulations under 40 CFR Part 61, Subpart M require a thorough asbestos inspection, advance notification to the applicable FDEP district office or local program at least 10 working days before demolition begins, and complete abatement by a licensed contractor before demolition of any facility that contains regulated asbestos-containing materials (ACM). Florida DBPR issues a separate asbestos contractor license; a demolition contractor cannot legally perform asbestos removal unless independently licensed for that scope. Lead-based paint on steel structures, pilings, and equipment also requires licensed removal and documented disposal. Florida’s asbestos and hazardous materials requirements for demolition cover the full regulatory picture for ACM and lead paint on older structures.

CCA-Treated Timber

Older piers, docks, and fender systems frequently use chromated copper arsenate (CCA)-treated timber. Under federal RCRA regulations, CCA-treated wood is generally exempt from classification as hazardous waste, but it cannot be disposed of at unlined C&D debris facilities in Florida due to arsenic leaching concerns. FDEP’s CCA-treated wood guidance specifies best management practices for collection, recycling, and disposal, and the material must be segregated from standard construction debris and routed to an authorized facility. This is an item that must appear in the project’s waste management plan before demolition begins. Contractors who do not flag this during pre-construction planning are a concern.

Turbidity and In-Water Controls

Demolition activity in or near water generates turbidity: suspended sediment that can smother seagrass, harm fish habitat, and violate water quality standards. Both USACE and FDEP permits for in-water work typically require turbidity curtains around active work areas and turbidity monitoring throughout the project. Contractors must have experience deploying and maintaining these controls, and permit conditions typically specify the turbidity thresholds that trigger a work stoppage.

Working on a Waterfront or Coastal Demolition Project in Florida?

PAW Demolition has performed coastal and waterfront demolition in the Tampa Bay area, including seawall demolition in St. Petersburg with PCL Construction and the City of St. Petersburg. We handle permitting in-house and manage the full scope from structural demolition to debris hauling and site restoration.

Talk to a Demolition Expert

How to Qualify a Contractor for Waterfront Demolition Work

The permitting complexity and environmental risk of waterfront demolition make contractor selection more consequential than on a standard commercial project. The right contractor brings relevant experience, the right license, and a safety record that reflects how they actually manage complex, high-hazard environments.

Licensing

Florida requires a Division I General Contractor license, or an appropriate specialty license under Florida Statute §489.105, to act as the prime demolition contractor and pull permits. Subcontractors working under a licensed GC on a permitted project are covered under §489.113(2) for that purpose. If asbestos abatement is in scope, a separate DBPR asbestos contractor license is required regardless of how the prime contract is structured. Florida’s contractor licensing structure for demolition work breaks down the full state framework for anyone verifying a contractor’s standing before award.

Coastal and Marine Demolition Experience

Seawall, bulkhead, and pier demolition requires equipment and crews familiar with tidal constraints, water-adjacent debris containment, barge access, and the specific techniques involved in removing pile-supported structures without destabilizing adjacent soil or infrastructure. This experience does not transfer automatically from standard commercial demolition. Ask for documented project history that includes actual waterfront or coastal structures, not just projects that happened to be located near water.

PAW Demolition’s work on the Bear Creek seawall in St. Petersburg involved the removal of a concrete seawall cap and steel sheet pile wall, vegetation clearing, backfill with PAW soil, and construction of a rip-rap buffer using 8″ to 18″ aggregate. That project was completed in coordination with PCL Construction and the City of St. Petersburg.

Safety Record

A contractor’s Experience Modification Rate (MOD rate) is one of the clearest indicators of how they manage safety across complex, hazardous scopes. The industry average MOD rate is 1.0. PAW Demolition carries a 0.72 MOD rate, which reflects 43 years of safe execution across industrial, heavy civil, and coastal demolition projects. Evaluating a demolition subcontractor’s safety record is worth reviewing if this is your first time qualifying a demo sub for a high-risk scope.

Owned Equipment and Self-Performance

Waterfront demolition requires heavy equipment: long-reach excavators, concrete processors, and haul trucks capable of managing large volumes of concrete and steel debris. Contractors who own their fleet and self-perform the work have tighter control over mobilization timelines and on-site sequencing than those who broker subcontractors. For projects with tidal access windows or tight permit conditions, that control matters. PAW Demolition’s industrial demolition capabilities include an owned equipment fleet with no outsourced crews on demolition scope.

How a Waterfront Demolition Project Typically Unfolds

Project sequencing on a waterfront demolition job is not arbitrary. It reflects permit conditions, environmental protection requirements, and the practical logistics of working between land and water. Here is the general progression GCs should expect:

  1. Pre-demolition survey and hazmat assessment. A licensed engineer performs a structural survey under 29 CFR 1926 Subpart T. A hazardous materials inspector surveys for asbestos, lead paint, and CCA timber.
  2. Permit applications. USACE Section 10, FDEP ERP, and local building permits are submitted. Pre-application meetings with USACE and FDEP are advisable for Individual Permit scopes.
  3. Utility and system disconnection. All utilities serving upland structures are disconnected and verified in writing before demolition begins.
  4. Hazardous material abatement. Licensed abatement contractors remove ACM and lead paint under their respective regulatory programs. CCA-treated timber is segregated and staged for disposal at an authorized facility. Documentation is required for permit compliance and closeout.
  5. Upland structural demolition. Buildings, crane structures, and other upland improvements are demolished and debris is removed before water-side work begins.
  6. Water-side demolition. Seawalls, bulkheads, piers, and pilings are removed with turbidity controls in place. Work windows may be constrained by tidal conditions or permit-specified seasonal restrictions to protect marine habitat.
  7. Debris handling and material recovery. Concrete is hauled for recycling, steel is salvaged, CCA timber goes to a certified disposal facility.
  8. Site restoration and final inspection. Backfill, grading, and any required shoreline stabilization are completed. Final inspections close out the local building permit and fulfill permit conditions for USACE and FDEP.

Pro Tip: Seasonal work restrictions are common in waterfront demolition permits, particularly near seagrass beds or in areas with active fish spawning activity. If your project is permitted in the fall and work windows close in spring, a contractor who falls behind on sequencing may not be able to restart until the following season. Tight project management and early mobilization matter more here than on a standard commercial teardown.

The Bottom Line on Waterfront Demolition in Florida

  • Plan for six or more months of permit lead time on Individual Permit scopes. Starting permit coordination at contract award is already too late on most projects.
  • USACE and FDEP permits run independently. Having one agency’s approval does not mean the other is forthcoming. Both must be in hand before in-water demolition begins.
  • Require a hazardous materials survey and abatement plan before any structural work begins. CCA-treated timber is the item most often overlooked on coastal projects.
  • Do not award coastal demolition scope to a contractor whose experience is limited to standard commercial teardowns. Verify project history with actual waterfront or marine structures.
  • A debris and materials management plan should be part of the pre-construction package. Know where demolished concrete is going, how steel will be handled, and who is responsible for CCA timber disposal before the project breaks ground.
  • Seasonal permit conditions can shut down in-water work for weeks or months. Build this into the project schedule upfront, not after a work stoppage.

Frequently Asked Questions

Who is responsible for permit coordination on a waterfront demolition project, the GC or the demo sub?

This depends on how the contract is structured, but in most cases the GC holds overall responsibility for obtaining permits on a project where they are the prime contractor. On projects where the demolition contractor is the prime, they carry that responsibility. What matters most is that roles are defined in the contract before pre-application meetings begin. FDEP and USACE permit applications require engineering documentation, site plans, and environmental assessments that need input from multiple parties. Ambiguity about who is coordinating the process causes delays.

Do tidal conditions affect how waterfront demolition is scheduled?

Yes, significantly. Access to seawalls, pilings, and submerged structural elements is often constrained by tide levels. Low tide windows give crews better access to below-waterline components, and some permit conditions specify that certain in-water activities may only occur during defined tidal windows to minimize turbidity and habitat disturbance. Contractors without experience working to tidal schedules often underestimate how much this compresses effective working time on a given day.

Does waterfront demolition cost more than standard commercial demolition?

Generally, yes. The cost premium reflects several factors: multi-agency permitting requires more time and often engineering support; hazmat abatement on older marine structures frequently involves CCA timber in addition to the asbestos and lead paint found on standard commercial buildings; in-water work requires specialized equipment and environmental controls; and debris disposal for treated timber and marine materials carries higher unit costs than standard construction debris. The major cost variables for commercial demolition in Florida apply here as well.

Can demolished seawall or pier concrete be recycled?

Yes. Demolished concrete from seawalls, pier decks, and upland structures can be processed into recycled concrete aggregate for use as road base, fill material, or drainage aggregate. This is contingent on the concrete not being contaminated with hazardous materials. Contractors with on-site concrete processing capability, like PAW Demolition’s recycling facility, can handle this in-house, which reduces haul-off costs and keeps material out of the waste stream. Confirm with your contractor whether recycled aggregate processing is part of their scope or whether material will be hauled to a third-party facility.

What happens if work begins without the required USACE or FDEP permits?

Unpermitted work in navigable waters is a federal and state violation. USACE can issue cease-and-desist orders and require restoration of the waterway at the responsible party’s expense. FDEP has independent enforcement authority and can impose fines and require remediation under Florida’s environmental protection statutes. Beyond the regulatory penalties, unpermitted in-water work can complicate future permitting on the same site and expose the project owner to civil liability. The permit process for coastal demolition exists for enforceable reasons, and there is no practical shortcut.
